10
UL part numbers requalified and PPAP approved
Supplier exit: an incumbent left three legacy appliance product lines. RELY took the tooling and the responsibility.
Read Case Study No. 21

RELYAcross services·Program transfersProduction transfer
Program transfers · Contract manufacturing
RELY takes over defined manufacturing programs and runs them.
When a supplier exits, a product line needs a new home or your plant needs capacity, the program moves to RELY. Moving the equipment is the easy part. We take responsibility for the manufacturing around it: suppliers, materials, documentation, qualification and ongoing production.
Transfers can include assembly, service parts, wire harnesses and customer-owned equipment.
Three legacy product lines transferred. Ten UL part numbers requalified through PPAP.Case Study No. 21 · Major appliance OEM · Requirements vary by program
Start with the product family, current volume and why the work needs to move. An introductory conversation does not require a complete transfer package.

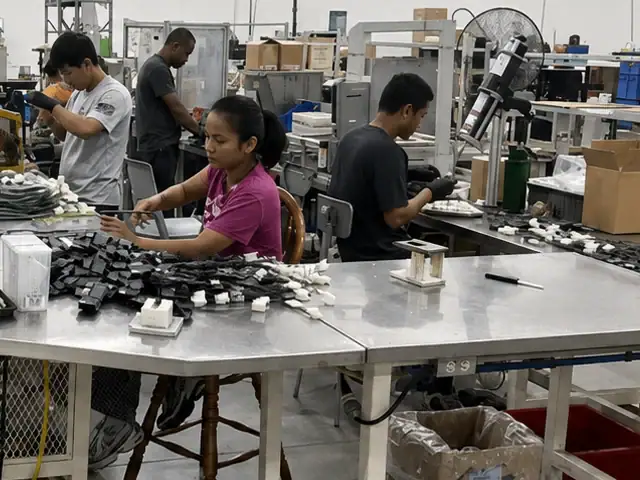

Washer lid switch line · RELY floor
When the current model no longer works
Production transfers happen for different reasons. An incumbent supplier exits. A mature product is consuming space needed for growth. Service parts no longer fit the main line. A supplier cannot support the required volume. Equipment exists, but the program needs a new operating home. The reason matters because it changes how the transfer should be planned.
Situation 01
Your current source is leaving the program, missing requirements or no longer supporting the work at the level the business needs.
Situation 02
A recurring program is consuming labor, equipment or floor space needed for higher-priority production. Moving it releases those people and that space for the work that needs them.
Situation 03
The product still needs reliable supply, but its volume, age or complexity no longer fits efficiently inside the original operation.
Situation 04
The work can be defined and controlled, but it does not need to consume your internal manufacturing resources.
The question is not simply, “Can someone else build it?” The question is:
Can the manufacturing responsibility move without losing control of supply, quality and execution?
Two transfers, two starting points
Both programs started with a specific reason to move. RELY took responsibility for what the move required, then kept production running.
10
UL part numbers requalified and PPAP approved
Read Case Study No. 21
<4 wks
From go-ahead to production at RELY
Read Case Study No. 13
Figures describe the named programs only. They are not a standard transfer timeline or a capacity commitment.
More than a machine move
The visible production equipment is only one piece of the transfer. The program around it may include years of supplier history, material commitments, workarounds, customer requirements and undocumented operating knowledge.
Drawings, BOMs, revisions, specifications, deviations and approved product requirements.
Work instructions, setup information, operator knowledge, process sequence and known failure modes.
Finished goods, raw materials, WIP, obsolete stock, customer-owned material and inventory in transit.
Supplier commitments already placed before the manufacturing responsibility changes.
Approved sources, pricing, lead times, MOQs, customer-directed suppliers and multi-tier supply relationships.
Production equipment, fixtures, gauges, test equipment, spare tooling, utilities and maintenance condition.
Inspection, testing, traceability, PPAP, first article, customer notification and production-release requirements.
The inventory, timing, validation and fallback plan required to keep shipments moving while the process changes hands.
A transfer is not complete because the truck arrived. It is complete when the receiving operation can repeatedly execute the program under controlled requirements.
The commercial handoff
Inventory ownership is one of the easiest transfer decisions to leave vague and one of the most expensive to untangle later. Before production responsibility changes, both teams need a defined plan for existing inventory, WIP, supplier commitments and future purchasing.
Model 01
Purchase existing inventory
RELY may purchase agreed usable inventory at an agreed valuation as part of the transfer.
Model 02
Consign until depleted
Customer-owned inventory transfers to RELY and is consumed before RELY transitions to future purchasing responsibility.
Model 03
Ongoing consignment
The customer continues to own agreed materials while RELY performs the manufacturing work.
Model 04
Hybrid
Different components follow different ownership models based on supply agreements, economics, lead times or customer requirements.
Each model is an arrangement reviewed for your program, not an option RELY accepts automatically. The structure is agreed in writing before cutover.
For each supplier commitment, determine whether the PO will be:

Settle this first

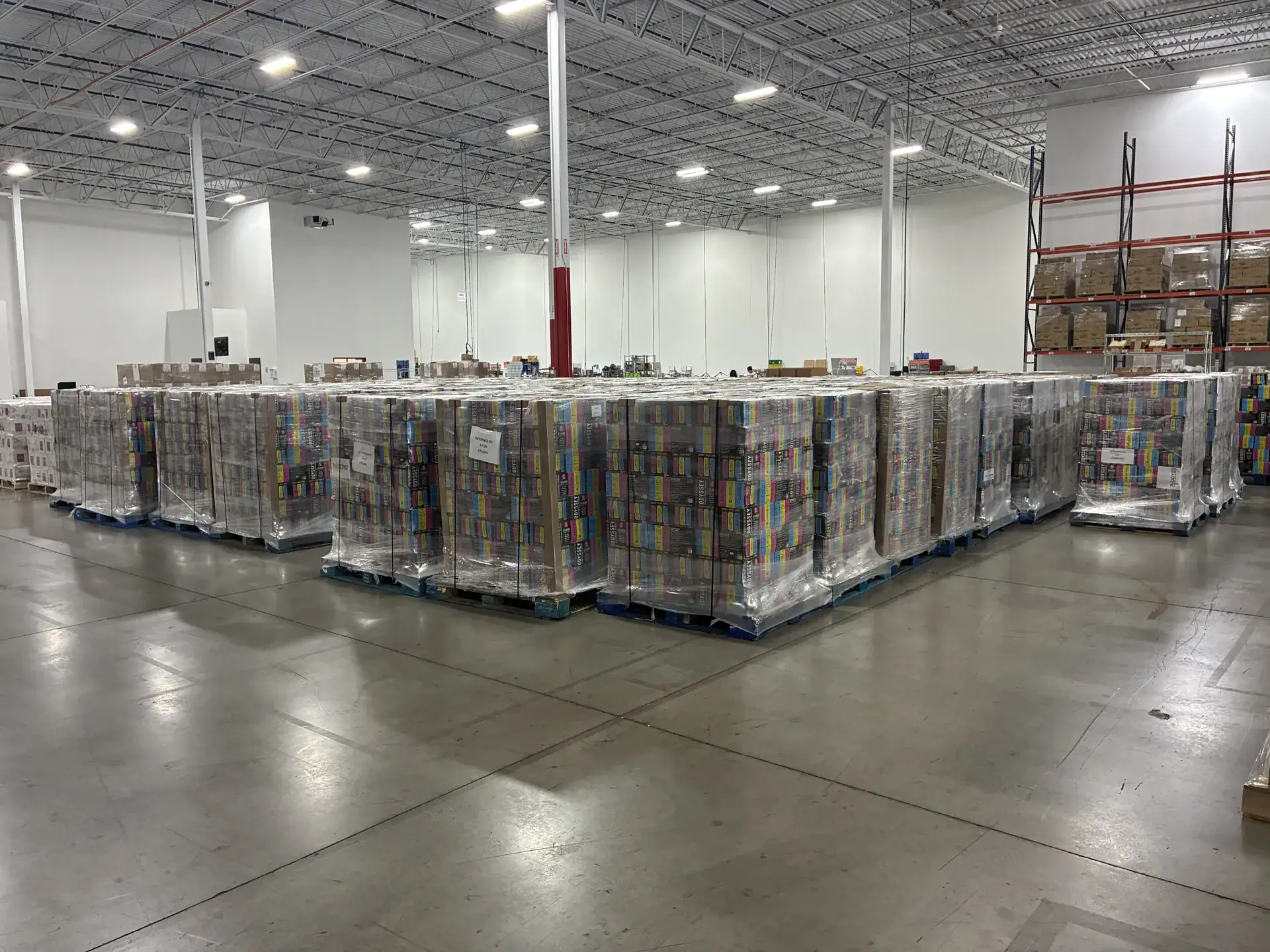

What is the inventory strategy at cutover?
Are we buying the existing inventory, consuming it on consignment, taking over open purchase orders, or transitioning through a combination of all three?
That answer affects working capital, supplier communication, excess inventory, launch timing and the future-state commercial model.
Talk through your inventory planEquipment & tooling
RELY can evaluate customer-owned equipment, tooling, fixtures and test systems as part of a transferred manufacturing program.
Before the move, the transfer team should understand the condition of the assets, required utilities, maintenance history, spare tooling, calibration needs, safety requirements and the process knowledge needed to operate them.
Do not move a mystery.
A transfer should not turn an existing equipment or maintenance problem into an unexplained launch problem.
Protect the customer first
The transfer schedule has to account for more than the equipment move. Existing inventory, open demand, customer approvals, material availability, pilot production and the receiving operation’s ramp all affect the safe cutover date.
The existing source keeps shipping.
Inventory built to cover the move.
RELY proves the process.
Your release criteria are met.
Responsibility changes hands.
Recurring cadence at RELY.
Depending on the program, continuity planning may include
How much supply do you need before you can safely stop the old process?
The answer depends on demand, material availability, transfer timing, approval requirements and the reliability of the receiving process.
Proven program transfer · Case Study No. 21
When a major appliance OEM’s incumbent supplier exited three legacy UL product lines, RELY took over the tooling and rebuilt the manufacturing system underneath it.
The hard part was never running the equipment. It was proving that someone else’s tooling, suppliers and manufacturing history could be requalified through full PPAP under RELY’s name.

From RELY Case Study No. 21 · Legacy Program Transfer · Major appliance OEM
Anyone can inherit the equipment. Very few suppliers will inherit the responsibility.
What RELY actually owned
What the first order can expose
An incumbent’s exit looks like a clean handoff: dies, anvils, testers and BOMs, boxed up and shipped. What doesn’t fit in the truck is years of undocumented knowledge, with none of the people who built it. In Case Study No. 21, the first production order surfaced two problems the transfer documentation never mentioned.
Incident 01 · Obsolete resin
RELY went directly to the resin manufacturer, identified two replacements meeting the full UL specification and purchased the material to keep the program moving. Both materials became PPAP-approved primary and secondary options.
Incident 02 · Failed custom anvil
The order was already overdue. Spare tooling included anvils with broken tips and others built for different rivets. The spare-parts box told part of the program’s history the transfer documentation didn’t.
Plan for it
Damaged tooling arrives back at RELY. Recovery begins.
The customer flags a shortage one week out. RELY gets an outside machine shop to reopen after hours.
The bridge fix produces the first good parts.
The bridge solution fails. The team immediately develops a second fix.
400 parts finished and shipped the same day. Three replacement anvils ordered as the permanent corrective action.
“Thank you for the extra effort from your team … working after hours to help us avoid a production impact.”
Established-process transfer · Case Study No. 13
Not every transfer starts with a supplier exit. A Wisconsin injection molder wanted mask assembly moved from out of state to sit closer to its molding operation. Before committing to the move, the customer needed real numbers on labor content and throughput, and any gap between the old line stopping and the new one starting put supply at risk.
RELY time-studied the assembly work so the labor requirement was known before the move, then had production running in under four weeks from go-ahead.
From RELY Case Study No. 13. The 210,689 total covers masks and the six additional product lines; it is not a mask total. Historical program results, not a standard transfer timeline.
Who owns what
A transfer goes wrong when two teams each assume the other owns a decision. The split below is typical. The actual split is agreed during scoping, and your team decides what it keeps.
Your team decides
Decided together
RELY can lead
How to start
Start with the product family, current volume, why the work needs to move and what worries you about the handoff: an exiting supplier, undocumented knowledge, material risk, equipment, approvals or timing. A part, a photo or the print helps if you have it.
You do not need a complete transfer package for that first conversation. RELY reviews what you share, identifies what still needs to be understood and recommends the next step, whether that is a time study, sample review, pilot or transfer plan.
| When | What helps |
|---|---|
| To start | Product family, current volume, why the work needs to move, target timing, and a part, photo or print if you have one. |
| During scoping | BOMs, drawings and revisions; inventory and open PO lists; equipment and tooling list. |
| Before pilot | PPAP, first-article and customer approval requirements, plus validation criteria. |
| NDA | Need one before sharing drawings? Tell us and we start there. |
The work runs on services RELY already operates
Contract Assembly & SubassemblyFinal assembly, subassembly and electromechanical builds, including legacy and service programs.View service → Part Sorting, Containment & ReworkInspection and containment when inherited inventory needs to be verified before it ships.View service → Kitting & Kit AssemblyKits, packaging and fulfillment for service parts and aftermarket programs.View service → Wire Harness & Cable AssemblyBuild-to-print harness and cable programs, 100% continuity tested.View service →Questions buyers ask
A transfer covers the manufacturing responsibility, not only the equipment. Depending on the program, that includes product definition, BOMs and revisions, process knowledge, existing inventory and open purchase orders, suppliers, equipment and tooling, quality and approval requirements, and the plan that keeps customer supply moving through cutover.
Full answer: taking over a product lineYes. RELY can evaluate customer-owned equipment, tooling, fixtures and test systems as part of a transferred program. Before the move, both teams document ownership, operating condition, maintenance history, utilities, spare tooling, calibration needs and who is responsible for rigging, transport and reinstallation.
Full answer: equipment transfersThat is defined per program and agreed in writing before production responsibility changes. Common models are RELY purchasing agreed usable inventory, consignment until depleted, ongoing consignment, or a hybrid by component. Each open PO gets its own plan: completed and transferred, consigned, assigned where commercially permitted, cancelled and reissued by RELY, split, or allowed to run out.
Full answer: materialsYes, where the program requires it. In Case Study No. 21, RELY requalified 10 UL part numbers through full PPAP under RELY’s name. Approval decisions stay with the customer and, where applicable, the end customer.
Full answer: PPAP and first articleIt depends on the program. Approval requirements, material lead times, equipment condition and installation, the size of the transfer bank and the receiving process’s ramp all set the timeline. RELY builds the schedule with your team after reviewing those dependencies instead of quoting a generic lead time.
Full answer: transfer timingYes. Many transfers start with a defined subset of SKUs or a pilot build, then expand once the process, materials and quality checks are proven. Staged transfers also reduce the supply risk of moving everything at once.
Full answer: pilotsWhere possible, yes. Finished-goods prebuild, safety stock, parallel production, pilot builds and customer approval can bridge the gap until RELY’s process is validated. The safe cutover date depends on demand, material availability and approval requirements.
Full answer: protecting supplyStart with the product family, current volume and why the work needs to move. A part, photo or print helps for a first look, but a complete transfer package is not required. Drawings, BOMs, inventory lists and open PO detail can follow during scoping. Need an NDA first? Tell us and we start there.
Full answer: quote inputsTell us the product family, current volume, why the work needs to move and what makes the handoff difficult. We’ll identify the right next step. A complete transfer package is not required to start.
Or call 262.276.0050 · info@relycm.com
