Wire spools and harness workstations in RELY’s electrical assembly area

RELYService family·Electrical assemblyControl panels & wire harness

For engineering, quality and supply chain

Electrical Assembly, Control Panels & Wire Harnesses

Control panels, control boxes and harnesses that arrive ready to install, not ready to diagnose.

Control panel, control box and enclosure assembly, plus build-to-print wire harnesses and cable assemblies, built to your drawings, schematics and BOMs. Harness workmanship is IPC/WHMA-A-620 aligned, and every completed harness is 100% continuity tested.

Electrical assembly area · RELY floor

Harness specs, up front

Can RELY build it? Check before you call.

From simple cable assemblies to harnesses with hundreds of components. Anything outside this range can be reviewed from the drawing or a sample, and we will tell you plainly if it is not a fit.

Current harness capability
CapabilityCurrent scope
Wire gauge8 through 22 gauge, multiple colors
Jacket materialsPVC, GXL, TXL, silicone, TPE
ConnectorsCurrent examples: Bosch, Delphi/Aptiv, Deutsch, Molex, TE/AMP. Others reviewed per application.
ProtectionWoven braid, slit conduit, solid conduit, heat-shrink tubing, spiral wrap
Build methodCustom build boards made from customer prints
IdentificationLabeling and circuit identification to customer specification
WorkmanshipIPC/WHMA-A-620 aligned
Testing100% continuity testing on every completed harness. Other tests defined by the program.
Typical lead timeAbout 10 business days once required components are procured

Lead time depends on component availability and program requirements. Prototype, urgent, high-complexity, transferred or material-constrained programs may differ; the quote and launch plan govern.

Harness program basics

Verification

100%

Of completed harnesses continuity tested

Range

8-22

Wire gauge, current supported range

Lead time

~10

Business days typical, once components are procured

Workmanship

A-620

IPC/WHMA-aligned build standard

From RELY’s published capabilities and FAQ. Continuity testing confirms circuits; it does not by itself verify every mechanical, insulation, environmental or field requirement.

Scope

What RELY builds, and who owns what.

Panels & enclosures

Assembly to drawings.

Component mounting, DIN rail, terminal blocks, wiring and circuit labeling to your drawings, schematics and BOMs, with agreed inspection and testing.

Harness & cable

Manufacture to print.

Prototype, engineering builds, low-volume and production harnesses, cable assemblies and rework. Programs can stand alone or feed assemblies and kits.

Design authority

Stays with you.

Product design authority remains with you or your engineering owner unless a separate scope says otherwise.

Testing

Defined by the program.

Continuity on every harness. Custom test boards, mating harnesses and other electrical tests are added when the application requires them.

Listings

Reviewed at RFQ.

Product-listing or certification requirements are reviewed at the RFQ stage. RELY does not imply a listing outside its approved scope.

Testing & traceability

Verification built into the build, not bolted onto the end.

Continuity testing and the agreed workmanship and inspection checks help identify defects before release. Additional tests are defined by the application and customer requirements.

  1. Continuity

    Every completed harness is 100% continuity tested against the print.

  2. Workmanship & visual

    Visual and workmanship inspection to the agreed criteria, because continuity alone does not verify mechanical requirements.

  3. Insulation tests when specified

    Hi-pot or insulation-resistance testing can be defined for a program. It is not included on every build unless your requirements call for it.

  4. Label verification

    Circuit identification and labels checked before release.

  5. Build records

    Batch-level build records, with serial-level traceability where your program requires it.

  6. Customer documentation

    Customer-specific documentation retained digitally with the build records.

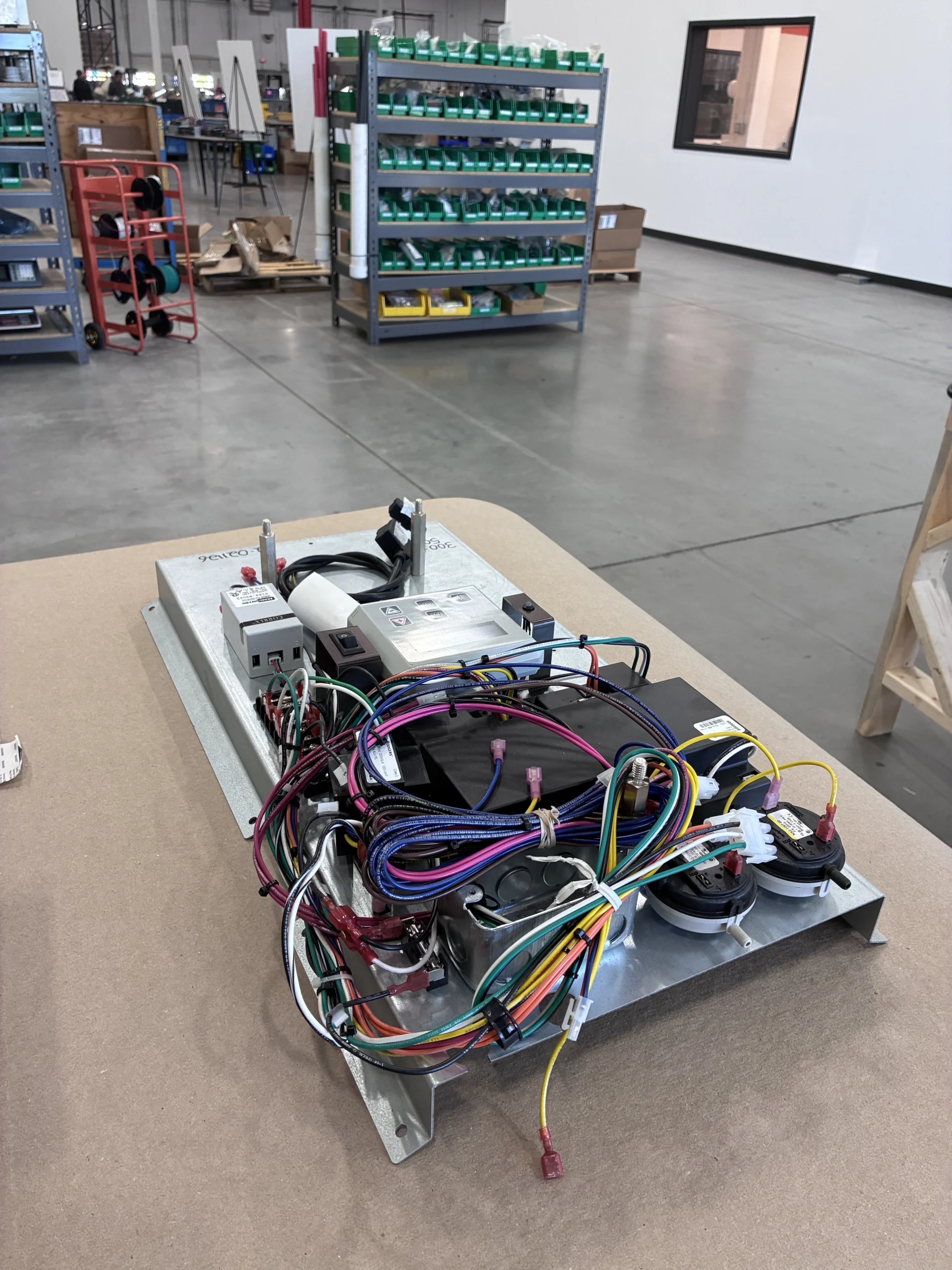

A control box with mounted components and wiring on an assembly bench
Control box assembly · RELY floor

Control boxes & panels

Same layout, same wire path, every unit.

Consistent component placement, defined wire paths, secure terminations and clear labeling, so your team is not troubleshooting wiring differences from one unit to the next.

  • Breakers, relays & power supplies
  • DIN rail components
  • Final electrical verification
  • Sensors & terminal blocks
  • Torque verification where required

Panel evidence · Case Study No. 20

A water heater manufacturer first moved subassembly production and component procurement to RELY to take pressure off its main line. Control panel assembly followed as Phase 2 of the same program. The case’s published space and labor results describe the subassembly scope; it does not report panel output separately.

Case study · Thermal management wire harnesses

Engineering was building harnesses. RELY took them on.

A thermal management manufacturer’s engineers were building prototype, engineering-build and service harnesses while chasing parts, tooling and print clarifications. RELY took over estimating, procurement, build, test and program management.

  • JIT procurement with supplier coordination and min/max replenishment
  • A managed catalog of 130+ connector SKUs with engineering change control
  • Print review during quoting to flag incompatibilities and print errors before production
  • In-house braiding and labeling; 100% continuity testing before shipment
174
Harnesses produced in 2025
28
Different SKUs in 2025
300
Components in the most complex harness
$20K
Stagnant inventory eliminated

Source: RELY thermal management wire harness case study. Figures apply to this program only.

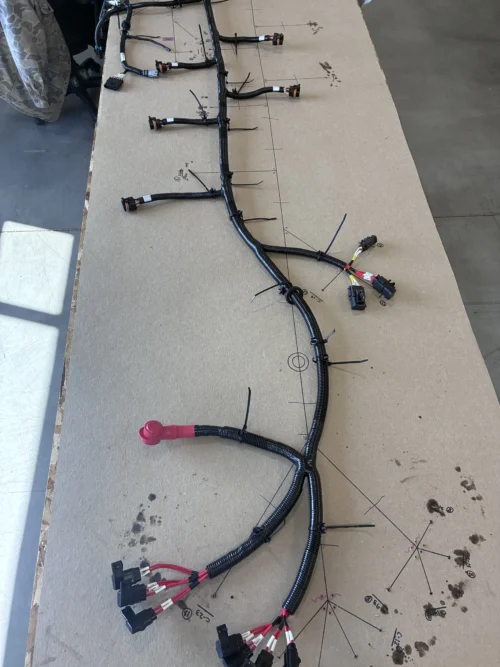

A wire harness laid out on a build board
Harness build board
An operator routing a harness on a board before test
Harness build & test

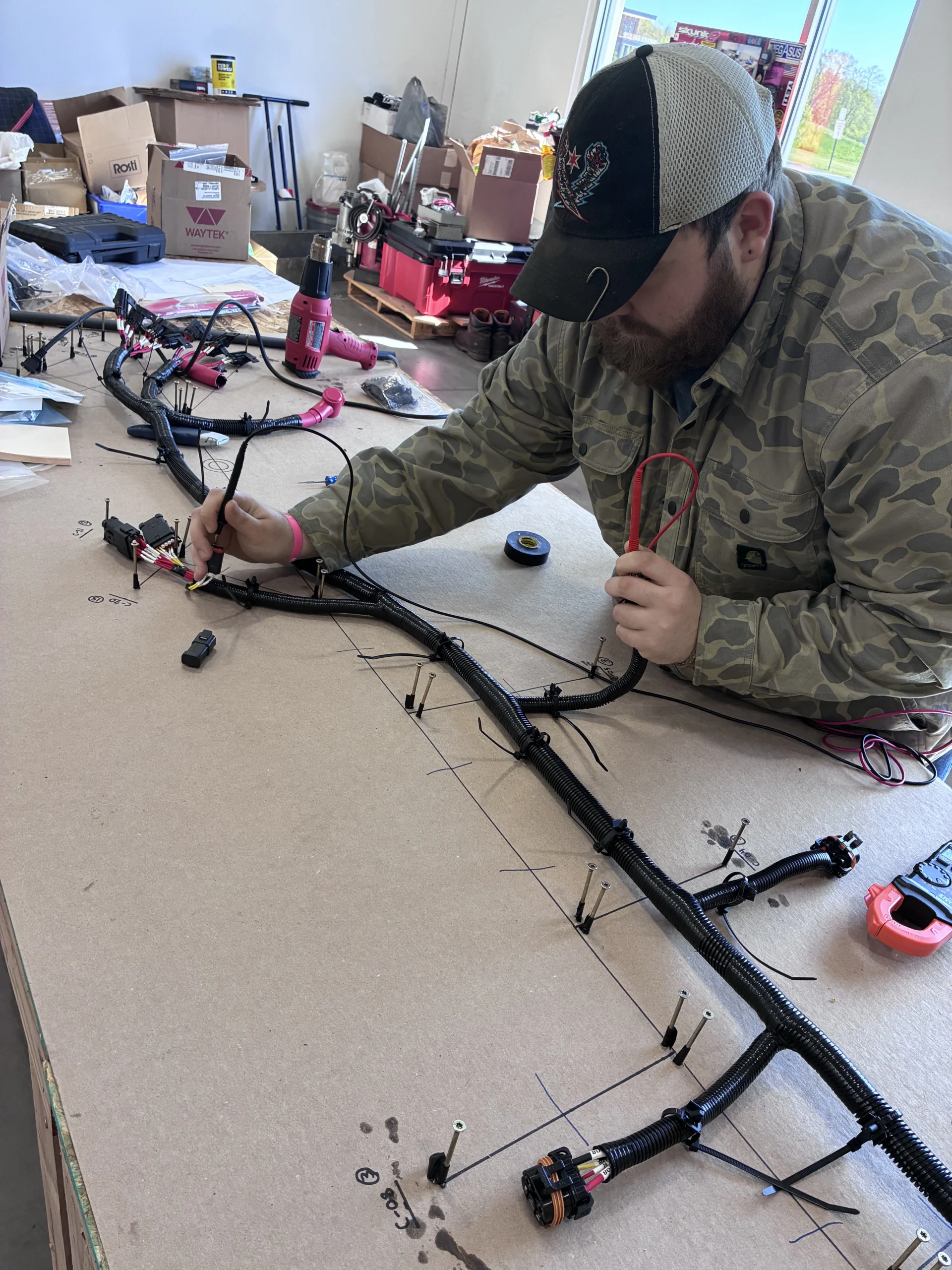

An operator performing electrical testing at a bench
Electrical testing

Lifecycle support

From first article to the last service part.

  1. 01

    Prototype

    Builds that prove the design and the process. New prototype cycles can include materials, tooling and board build.

  2. 02

    Pilot runs

    First articles, sign-off and process lock.

  3. 03

    Production ramp

    Structured cells and documented work instructions.

  4. 04

    Changes & service

    Engineering changes and warranty builds under revision control.

  5. 05

    Transfers & legacy

    Harness programs moved from another supplier, starting with a documentation and sample review.

Questions engineers ask

Short answers. Full answers in the FAQ.

How are harnesses tested?

Every completed harness is 100% continuity tested. Custom test boards or mating harnesses can be developed when appropriate. Electrical testing is combined with workmanship and visual inspection, because continuity alone does not verify every mechanical or application requirement.

Full answer: testing

Who procures the components?

Either side, or both. RELY can procure components, you can supply or consign them, or the program can use a hybrid. The quote defines who buys what, approved suppliers, ownership and how shortages and engineering changes are handled.

Full answer: materials

Can RELY take over a harness program from another supplier?

Yes. A transfer usually starts with approved drawings, samples, the BOM, open demand, components, build boards, test requirements, tooling and workmanship criteria. RELY identifies documentation gaps, material risks and tooling needs before setting the transfer plan.

Full answer: harness transfers

What drives lead time?

The standard build target is about 10 business days once required components are procured. Component availability, complexity, prototype or urgent status, transfers and material constraints can change it. The quote and launch plan govern the specific project.

Full answer: lead time

Can we start with one panel or control box family?

Yes. Start with the drawings, schematics, BOM, expected demand and how the unit is tested today. RELY reviews the layout, wire paths, component supply and verification steps, then scopes a first build or pilot before recurring production. In Case Study No. 20, control panel assembly was added as the second phase of an existing subassembly program.

Read Case Study No. 20

Does RELY build listed control panels?

RELY assembles control panels, control boxes and enclosures to your drawings, schematics and BOMs. Product-listing or certification requirements are reviewed at the RFQ stage so that no listing is implied outside RELY’s approved scope.

Full answer: control panels

Discuss your panel, control box or harness program.

Start with a description, the drawing or schematic number, how the unit is tested today and your expected demand. Need an NDA before sharing drawings or BOMs? Tell us first and it is handled before files are exchanged. After first contact, RELY sends a controlled file-sharing link for drawings, BOMs and specifications.

Or call 262.276.0050 · How drawings and NDAs are handled
